Updated for 2026 Ontario construction conditions
A fourplex might seem straightforward at first glance: four units on one lot under a single building permit. But once you get into the details, the budget is influenced by far more than just framing, drywall, and finishes.
In the GTA, the actual cost of building a custom fourplex in 2026 depends on several factors, including the quality of construction, site conditions, municipal fees, servicing capacity, HST, financing, and how smoothly the design and approval process unfolds. For most custom fourplex projects in Toronto, Vaughan, and Richmond Hill, hard construction costs typically range from 325to550+ CAD per square foot, not including land, HST, development charges, financing, or soft costs.
There is a good reason that range is so broad. A compact, rental-oriented fourplex on a simple site is a very different project from a larger infill development with below-grade complications, higher-end interiors, and a longer, more complex approvals process.
This guide is designed to help you put together a realistic planning budget for 2026 before you invest significant time and money into design, acquisition, or construction.
First, What Kind of Fourplex Are We Talking About?
For this article, “fourplex” means a purpose-built or substantially rebuilt residential building with four self-contained units on one property. It is not a cosmetic renovation of a detached house, and it is not a large apartment building.
That distinction matters because a proper fourplex budget needs to account for:
- multi-unit building code requirements,
- fire and acoustic separation,
- separate mechanical and electrical planning,
- parking or no-parking strategy,
- servicing capacity,
- municipal approval timelines,
- rental or resale performance after completion.
At Route Homes, we usually see fourplex feasibility conversations fall into two groups: homeowners trying to unlock more value from an existing lot, and investors looking for long-term rental income in established GTA neighbourhoods.
Those two groups ask different questions, but the budget logic is the same.
2026 Fourplex Construction Cost Per Square Foot
The table below shows planning-level hard construction costs for a custom fourplex in the GTA in 2026.
These figures refer to construction only. They do not include land, HST, development charges, permit fees, architectural design, engineering, financing, or contingency.
| Build Level | Typical Positioning | 2026 Hard Construction Cost |
|---|---|---|
| Standard / Rental-Focused | Durable finishes, efficient layouts, limited custom detailing | 325-375/sq. ft. |
| Premium | Better finishes, stronger curb appeal, improved unit layouts | 380-450/sq. ft. |
| Luxury / Highly Custom | Higher-end interiors, more complex design, custom details | 460-550+/sq. ft. |
A lower number is not impossible, but in the GTA it usually means something has been simplified: the design, the structure, the finish package, the site scope, or sometimes the assumptions behind the estimate.
That last one is where owners get into trouble.
A fourplex budget that excludes servicing, soft costs, DCs, HST, and financing may look attractive in the beginning. It usually becomes painful later.
What a Fourplex May Cost Before Land

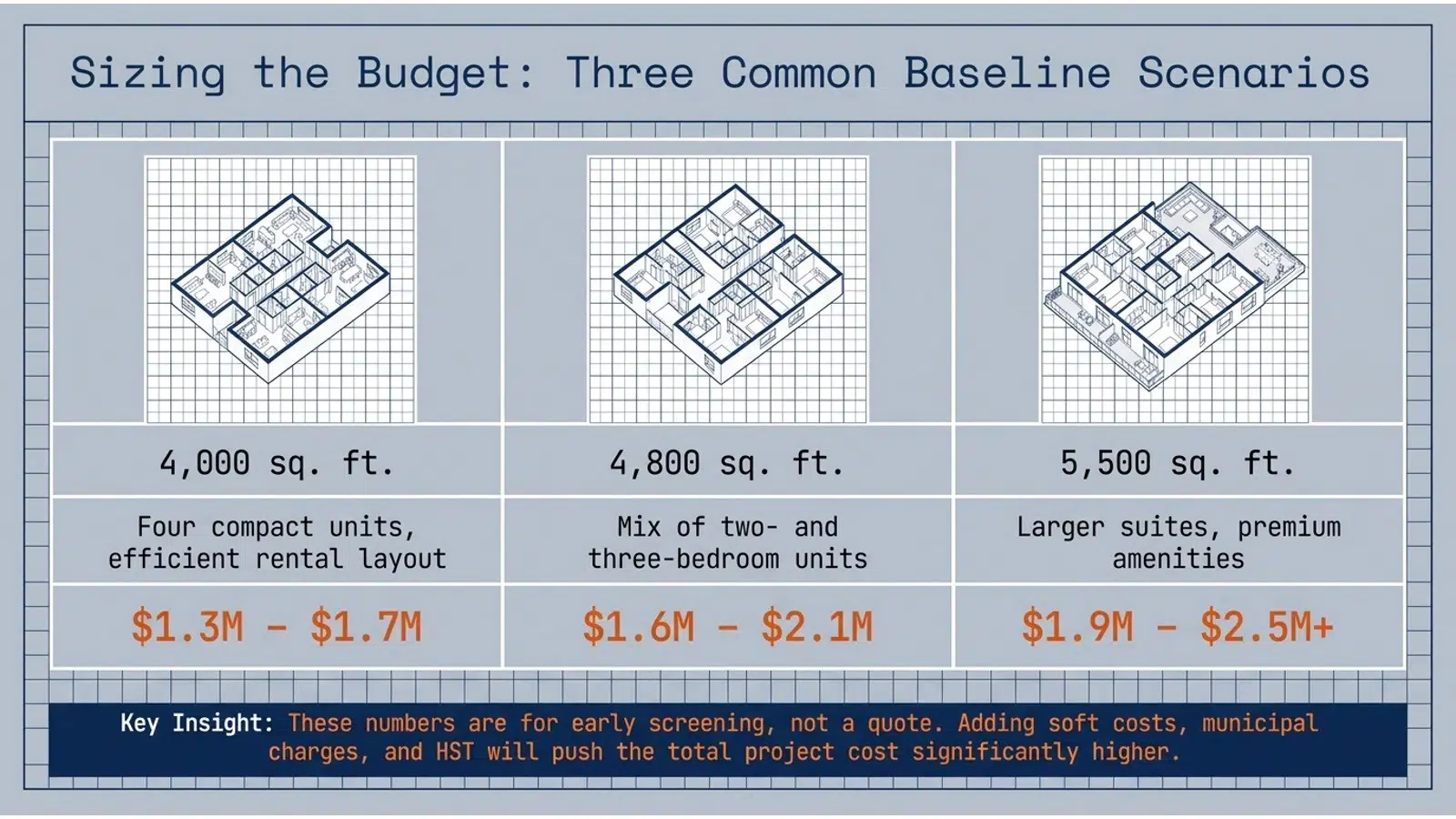

To make the numbers easier to visualize, here are three common size scenarios.
Again, these are hard construction ranges only.
| Approx. Finished Area | Possible Unit Mix | Estimated 2026 Hard Construction Cost |
|---|---|---|
| 4,000 sq. ft. | Four compact units, efficient rental layout | 1.3M-1.7M |
| 4,800 sq. ft. | Mix of two- and three-bedroom units | 1.6M-2.1M |
| 5,500 sq. ft. | Larger suites, stronger finishes, more amenities | 1.9M-2.5M+ |
These numbers are useful for early screening. They are not a quote.
A proper project budget should also include soft costs, municipal charges, HST cash flow, demolition if required, financing, and a contingency. Once those are added, the total project cost can move significantly above the construction number.

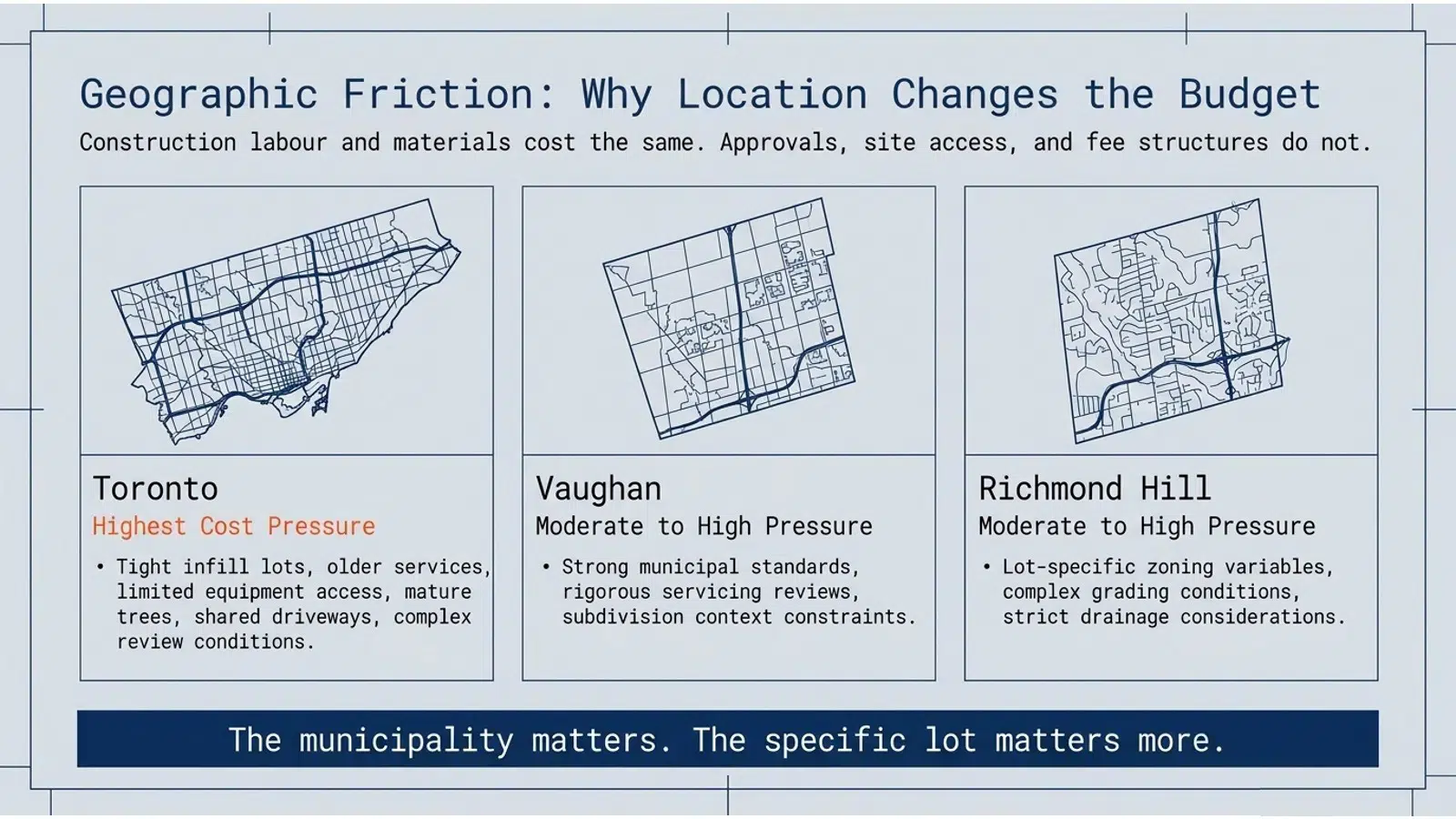

Toronto vs. Vaughan vs. Richmond Hill: Why Location Changes the Budget
Construction labour and materials do not magically become cheap when you cross a municipal boundary. But the site, approvals, access, and fee structure can change enough to affect the final budget.
| Area | Cost Pressure | What Usually Drives It |
|---|---|---|
| Toronto | Highest | Tight infill lots, older services, access limits, complex review conditions |
| Vaughan | Moderate to high | Strong municipal standards, servicing review, subdivision context in some areas |
| Richmond Hill | Moderate to high | Lot-specific zoning, servicing conditions, grading and drainage considerations |
Toronto often carries the most friction. Not always, but often.
Older neighbourhoods may have narrow lots, limited staging space, mature trees, shared driveways, older sewer connections, or neighbouring structures close to the property line. These are not abstract design issues. They affect excavation, equipment access, utility work, schedule, and risk.
Vaughan and Richmond Hill can be more forgiving on some sites, especially where access is better. But they are not automatically “easy.” A site with grading issues, servicing constraints, or zoning complications can quickly become more expensive than expected.
The municipality matters. The lot matters more.
The Budget Items People Often Miss
The construction number gets the most attention because it is easy to compare. But the real budget is built from several layers.
| Cost Category | Typical Role in the Budget | Planning Notes |
|---|---|---|
| Hard Construction | Labour, materials, site work, building systems | Usually the largest line item |
| Soft Costs | Architecture, engineering, surveys, planning, permit drawings | Often underestimated by first-time builders |
| Municipal Fees & DCs | Development charges, permit fees, municipal reviews | Must be checked by address and municipality |
| HST | 13% tax on many construction-related costs | Cash flow impact can be significant |
| Financing & Carrying Costs | Interest, lender fees, insurance, taxes during the project | Increases when approvals or construction are delayed |
| Contingency | Reserve for unknowns | Usually 10–15% for planning purposes |
For early budgeting, many owners look only at the first row.
Experienced builders look at all six.
Development Charges Can Change the Feasibility
Development Charges, or DCs, are one of the most important non-construction costs in a fourplex budget.
They vary by municipality and can change based on project type, timing, unit count, existing use, exemptions, credits, and local rules. In Toronto, Vaughan, and Richmond Hill, you should never rely on a generic DC estimate from an old article or a neighbouring project.
The correct approach is to review the current municipal DC schedule and confirm how it applies to the exact property and proposed unit configuration.
For some fourplex projects, DCs may be manageable. For others, they can materially change the return on investment. This is why Route Homes treats DC review as part of early feasibility, not as a detail to be handled after design is complete.
HST: Budget for the Cash Flow, Not Just the Final Net Cost
Ontario’s 13% HST can create a large cash flow requirement during construction.
Some residential rental projects may be eligible for rebates, depending on structure, ownership, use, and compliance with the applicable rules. But rebates are not the same thing as not paying tax.
In many cases, the owner still needs to fund HST during the project and recover eligible amounts later.
That timing matters.
If your lender, accountant, and custom home builder are not aligned on how HST is being handled, the budget can look fine on paper and still become tight during construction. Before committing to a fourplex build, owners should speak with a qualified accountant about HST treatment, rebate eligibility, and documentation.
This is not an area for guesswork.
Soft Costs: The Part of the Budget That Keeps the Project Buildable
Soft costs do not feel exciting. They also do not feel optional once the project becomes real.
A fourplex may require architectural drawings, structural engineering, mechanical and electrical design, grading plans, surveys, energy compliance work, planning support, permit coordination, and revisions after municipal review.
For a custom fourplex in the GTA, soft costs can easily move into the low six figures, especially if the site requires minor variances or additional planning work.
Cutting corners here rarely saves money. A weak drawing set often shows up later as pricing gaps, site confusion, change orders, and permit delays. Good planning does not remove every surprise, but it reduces the expensive ones.
Zoning and Approvals: What Matters for Cost
This guide is not meant to be a full zoning manual. The key point is simpler: zoning and approvals affect both time and money.
Toronto has moved further than many municipalities in allowing multiplex housing in low-rise neighbourhoods, including permissions that opened the door to more fourplex opportunities. Outside Toronto, including parts of York Region, the rules can be more site-specific and may depend more heavily on local zoning, lot dimensions, parking standards, servicing, and municipal interpretation.
For a fourplex feasibility review, the early questions are usually:
| Question | Why It Matters |
|---|---|
| Is a fourplex permitted on this property as proposed? | Determines whether the path is straightforward or approval-heavy |
| Are variances needed? | Adds time, consultant costs, and uncertainty |
| Can existing services support four units? | May trigger costly upgrades |
| Is parking required or strategically avoidable? | Affects layout, unit count, and rentable area |
| Are there tree, grading, or drainage constraints? | Can affect both design and site costs |
The most common budget mistake is assuming that because fourplexes are becoming more accepted politically, every lot is automatically simple.
That is not how approvals work.

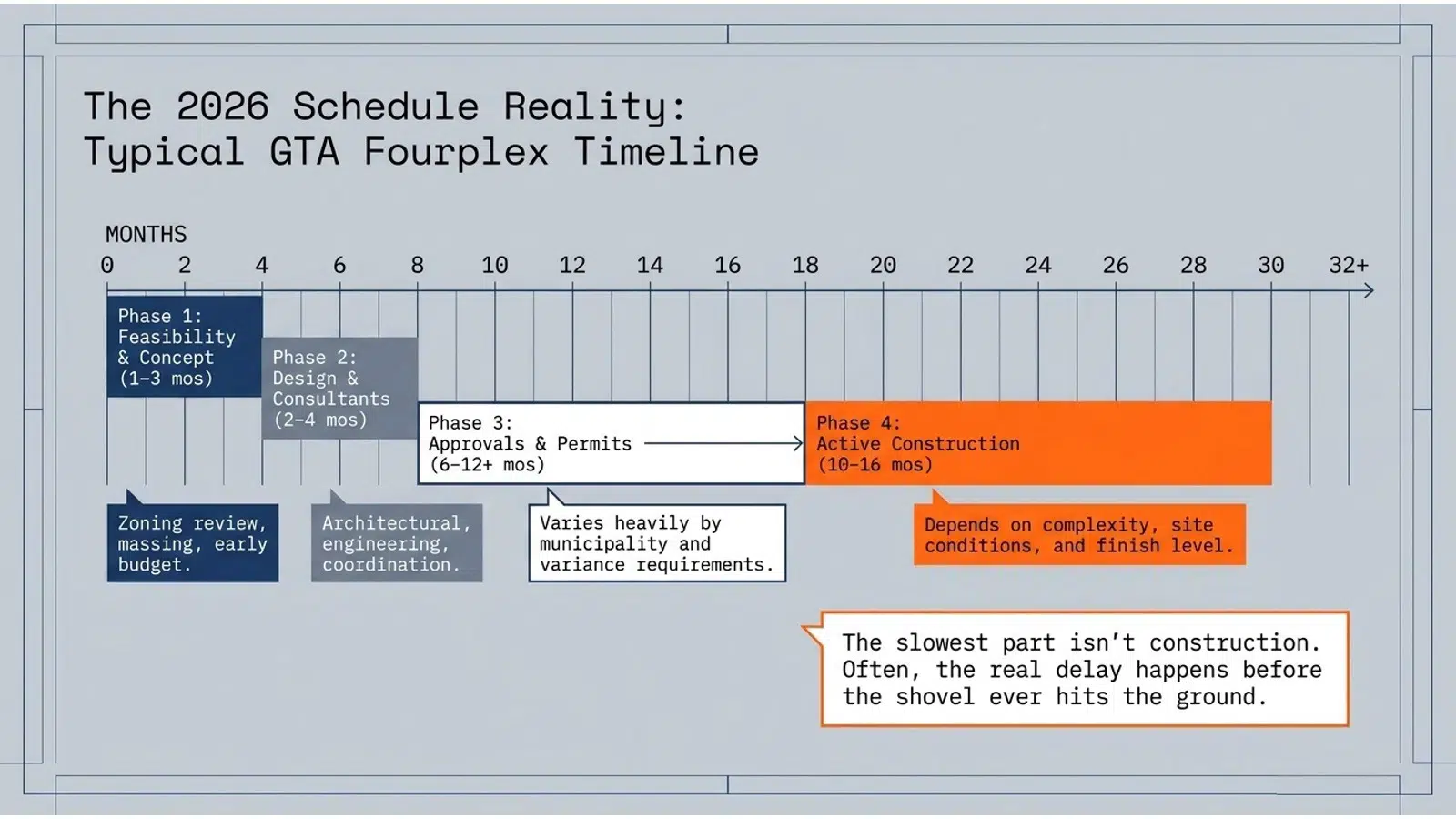

Typical Timeline for a GTA Fourplex in 2026
A fourplex is not usually a quick build. Even when construction itself is well managed, design and approvals take time.
| Phase | Typical Duration | Notes |
|---|---|---|
| Feasibility & Concept Design | 1–3 months | Zoning review, massing, early budget, unit strategy |
| Design Development & Consultants | 2–4 months | Architectural, engineering, grading, coordination |
| Approvals & Permit Review | 6–12+ months | Varies by municipality and whether variances are required |
| Active Construction | 10–16 months | Depends on complexity, season, site conditions, and finish level |
A clean, as-of-right project can move faster. A project requiring variances, servicing upgrades, or multiple resubmissions can take longer.
The slowest part is not always construction. Often, the real delay happens before the shovel hits the ground.

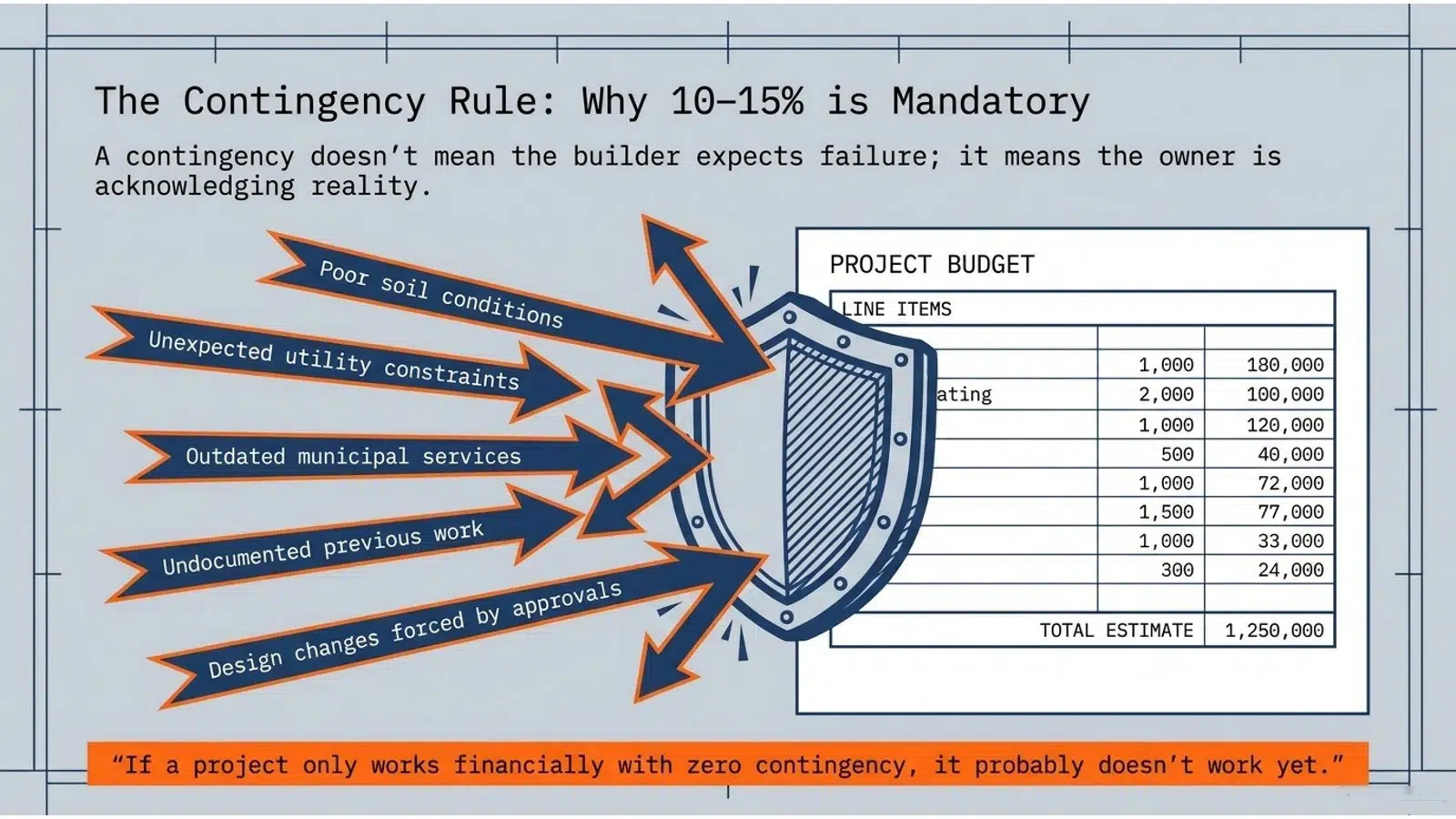

How Much Contingency Should You Carry?
For planning purposes, a 10–15% contingency is a sensible starting point for many custom fourplex projects.
That does not mean the builder expects the project to go wrong. It means the owner is acknowledging reality.
Older GTA lots can hide problems: poor soil, unexpected utility conditions, outdated services, drainage issues, undocumented previous work, or design changes triggered by approvals. Some are small. Some are not.
If a project only works financially with no contingency, it probably does not work yet.
That is one of the most useful tests in early feasibility.

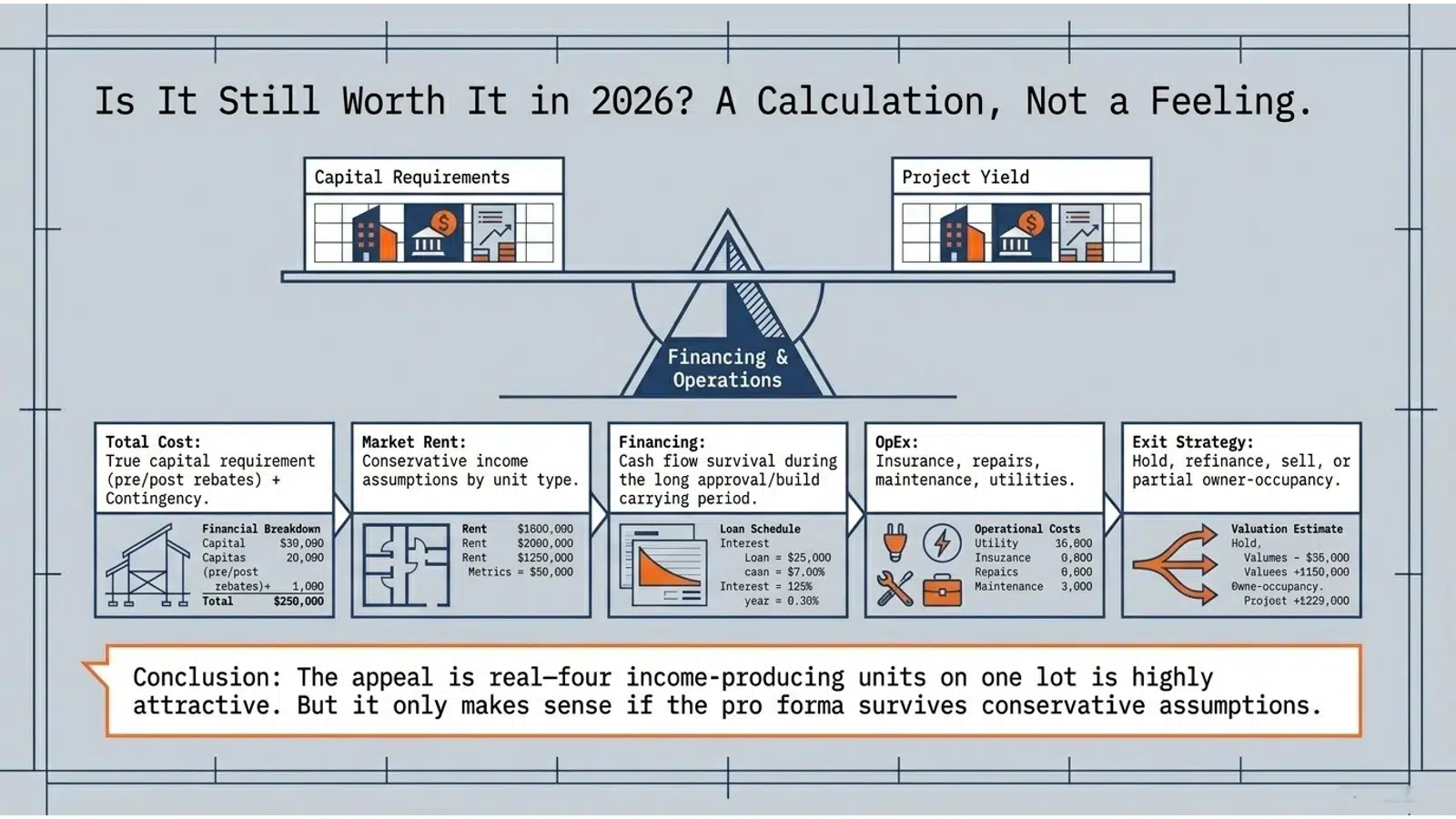

Is Building a Fourplex in the GTA Still Worth It in 2026?
It can be. But the numbers need to be tested carefully.
A fourplex may make sense when the land basis is reasonable, rents are strong, the unit mix is well designed, and the owner is prepared for a multi-stage process. It is less attractive when the project relies on optimistic rent assumptions, underestimated municipal costs, or a construction budget that leaves no room for delay.
The appeal is still real: four income-producing units on one urban lot, better land use than a single detached home, and long-term demand for well-located rental housing.
But feasibility is not a feeling. It is a calculation.
At minimum, the pro forma should test:
| Feasibility Factor | Why It Matters |
|---|---|
| Total project cost before and after rebates | Shows true capital requirement |
| Expected market rent by unit type | Drives income assumptions |
| Financing rate and carrying period | Affects cash flow during approvals and construction |
| Operating expenses | Insurance, repairs, maintenance, management, utilities |
| Exit strategy | Hold, refinance, sell, or partial owner-occupancy |
| Contingency | Protects the project from normal uncertainty |
If those numbers still work after conservative assumptions, the project deserves a deeper look.
2026 Planning Checklist Before You Commit
Before spending heavily on drawings or removing an existing structure, it is worth answering a few practical questions.
| Item to Confirm | Why It Should Be Checked Early |
|---|---|
| Current zoning and fourplex permissions | Determines the approval path |
| Lot size, depth, frontage, and access | Shapes building size and construction logistics |
| Existing servicing capacity | Can create major hidden costs |
| DC and municipal fee exposure | Affects feasibility directly |
| HST and rebate treatment | Impacts cash flow and financing |
| Construction budget range | Prevents design from outrunning affordability |
| Rental income assumptions | Tests long-term viability |
| Financing structure | Confirms whether the project can actually be funded |
This is the stage where many projects either become stronger or quietly stop.
Both outcomes are useful. A feasibility review should protect your capital, not just push the project forward
Get a Site-Specific Fourplex Feasibility Review
Online cost guides are useful for orientation. They cannot tell you whether your specific lot works.
If you are considering a custom fourplex in Toronto, Vaughan, Richmond Hill, or elsewhere in Ontario, Route Homes can help you review the major feasibility questions before you commit to a full design or construction budget.
A preliminary review can look at:
- zoning and approval path,
- approximate buildable area,
- construction budget range,
- soft costs and municipal cost exposure,
- HST and financing considerations,
- realistic project timeline.
To take the next step, send Route Homes your property address, rough project goals, and expected budget range through the contact us.
A short feasibility conversation early can save months of redesign and tens of thousands of dollars in avoidable assumptions.
